Projects  /  Career Tech High School

~450 Linear Feet · Glass Guardrail
304 Stainless Cap & Handrail

Career Tech High School

St. George, Utah  ·  2022 – 2023
Largest glass package we had built
Mahas Construction

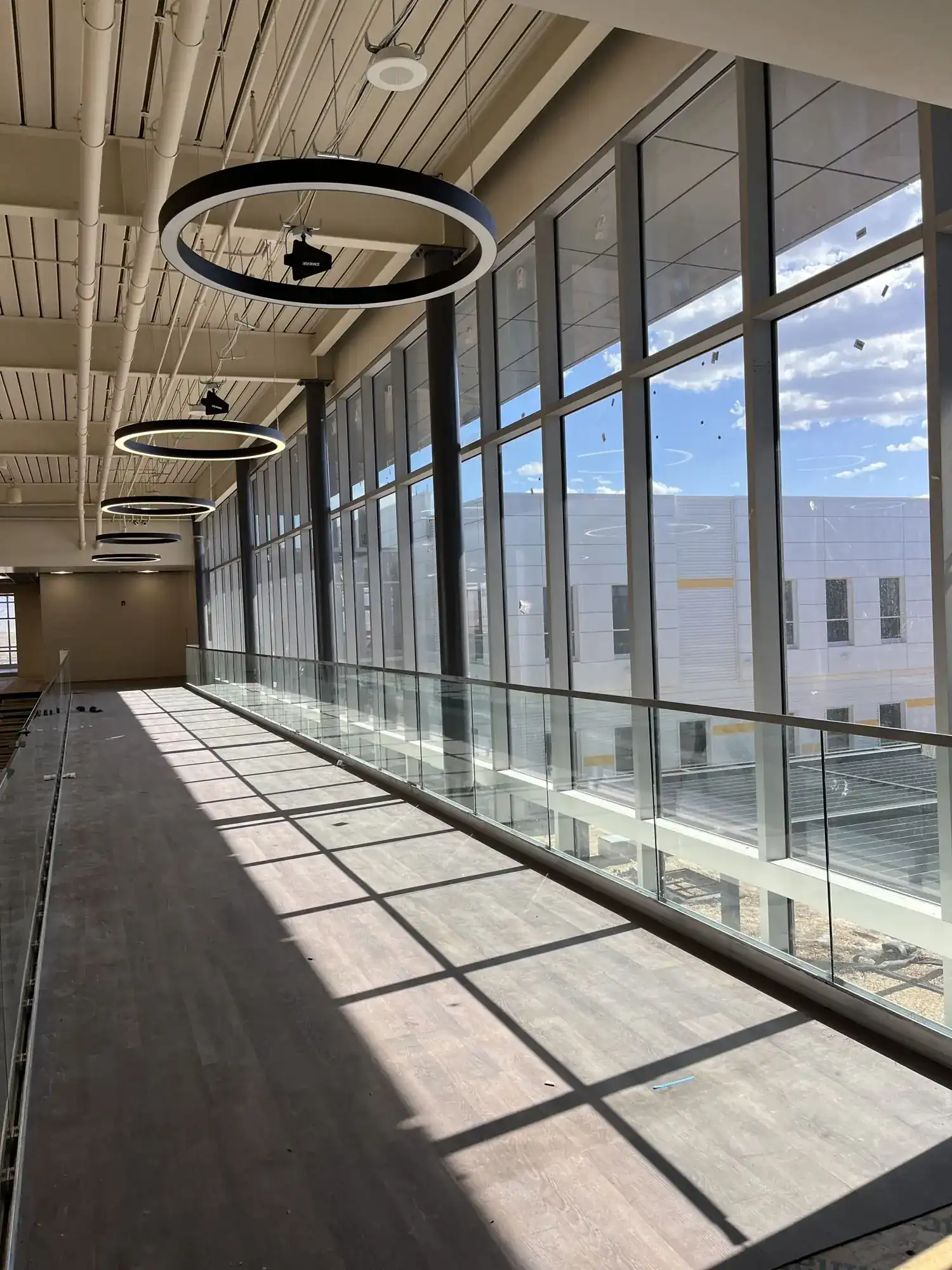

A long run of glass guardrail with stainless cap along a daylit upper corridor at Career Tech High School
General Contractor
Mahas Construction
Our Role
Fabrication
and installation
Metals
304 Stainless · Aluminum
base shoe, clad in stainless
Glass
Tempered laminated,
custom to our drawings
Finish
#4 brushed satin
Quantity
~450 Linear Feet

School starts in August.
That is the whole schedule.

Roughly 450 linear feet of glass guardrail through a new career and technical education high school — stair runs, mezzanine edges and long upper corridors, capped in 304 stainless with a #4 brushed satin finish. We fabricated the package and installed it. It was the largest single glass rail package we had built to that point.

A building where the date is the client

A school has one immovable constraint, and it is not in the specification. Students arrive in August. The district cannot push that, the contractor cannot push that, and no subcontractor gets to be the reason a building is not ready for them.

Every rail on this job sits on a stair or a mezzanine edge, which means it is life safety and it is on the critical path to occupancy. The certificate of occupancy does not get issued around a missing guardrail.

The job was also five hours from our shop. Logan to St. George is most of the length of Utah, which changes what a mistake costs and changes how a package has to be planned.

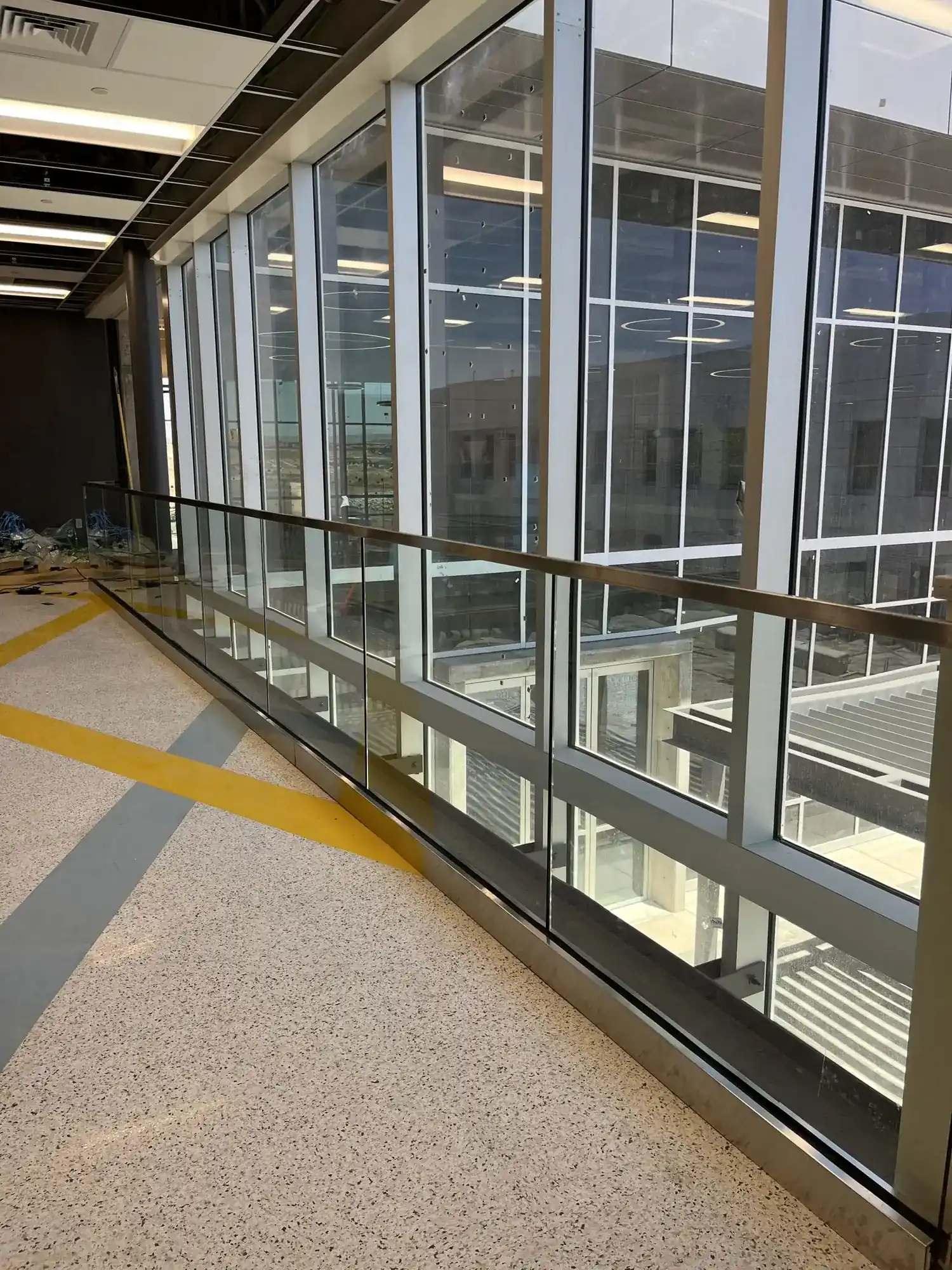

A long run of glass guardrail with stainless cap running the length of an upper corridor beside a full-height window wall

01 — The material

Glass does not negotiate

Steel forgives. If a post is out by a sixteenth you persuade it. Glass does not bend to meet a frame that is wrong — it either drops into the shoe or it does not, and the panel that does not fit is not adjusted, it is replaced.

Every panel here was a custom buyout, made by a glass manufacturer to our drawings. That is worth being plain about: the dimensions were ours. Nobody else in the chain was going to catch a panel size that was wrong, and a tempered laminated panel is weeks out, not days.

So the tolerance lives in the metal. An aluminum base shoe clad in stainless runs the length of every run, set and shimmed to the substrate before any glass arrives, because the shoe is the only part of the assembly that can be corrected on site.

The cap is 304 stainless in a #4 brushed satin finish, and the grain has to run continuously along hundreds of feet of rail that was fabricated in sections. A finish mismatch at a splice is visible from across a commons.

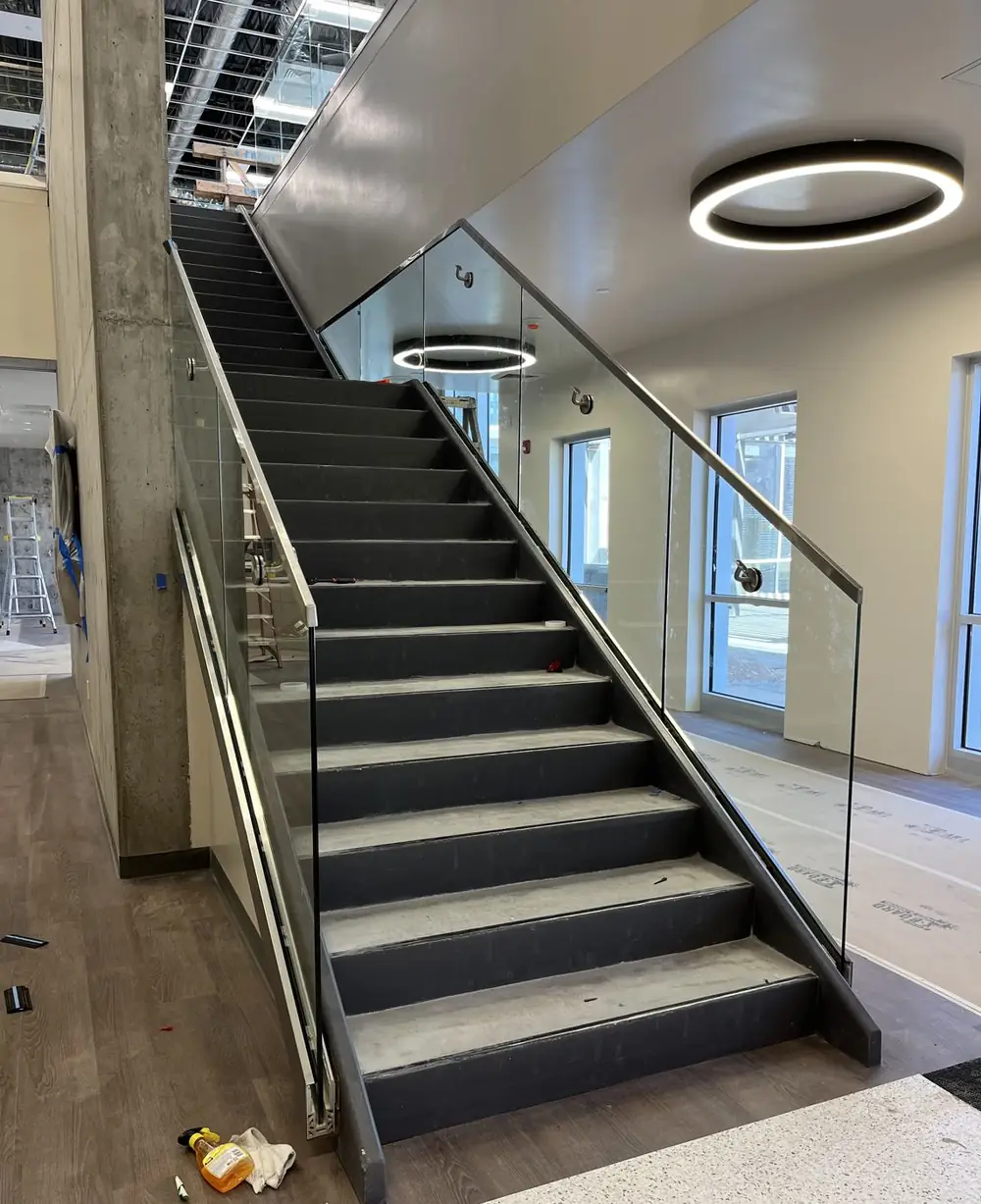

Finished stair with glass guardrail and brushed stainless cap rail at Career Tech High School
Stainless cap, #4 satin, grain running through.

02 — The distance

Five hours changes how you plan a package

On a local job, a missing bracket is an inconvenience. On a job in St. George it is a ten-hour round trip, or a shipment that arrives tomorrow at best — and tomorrow is a day the crew is standing on site either way.

That pushes the work upstream. Field measurements get verified before fabrication rather than during installation. Fasteners, shims, splice hardware and spares get loaded deliberately, because the hardware store five hours away does not stock stainless base shoe cladding.

It also means the crew that goes stays. You do not run a crew back and forth across a state — you send people who can finish what they start.

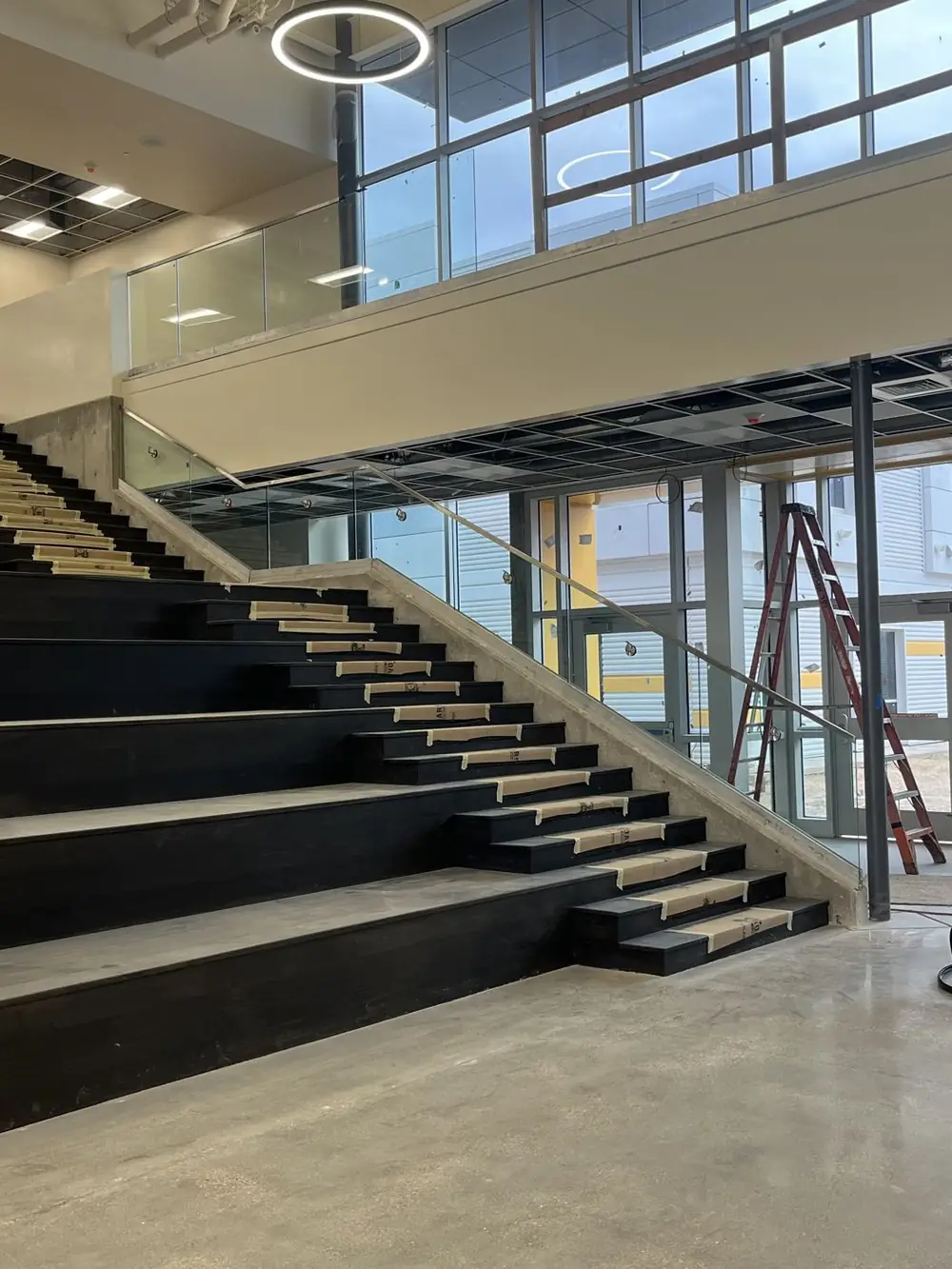

The main stair under construction, bare treads and open structure before rail or finishes
The main stair, before rail. Five hours from Logan.

03 — The scale of it

450 feet of a material we had never run this much of

We had built glass rail before. We had not built this much of it at once, and volume changes the problem — a system that works over twenty feet has to hold its line over an entire upper floor, through corners, across stair transitions, and past every variation the concrete gives you.

What carried it was treating the shoe as the precision component and the glass as the thing that simply has to be allowed to fit. That is the lesson that transferred: by the time we were setting 743 feet of guardrail into post-tensioned balconies at St. Regis, roughly half of it glass infill, the approach was already proven here.

A career and technical education school, incidentally, is a building full of students training for the trades we hire from. That was not lost on anyone who worked on it.

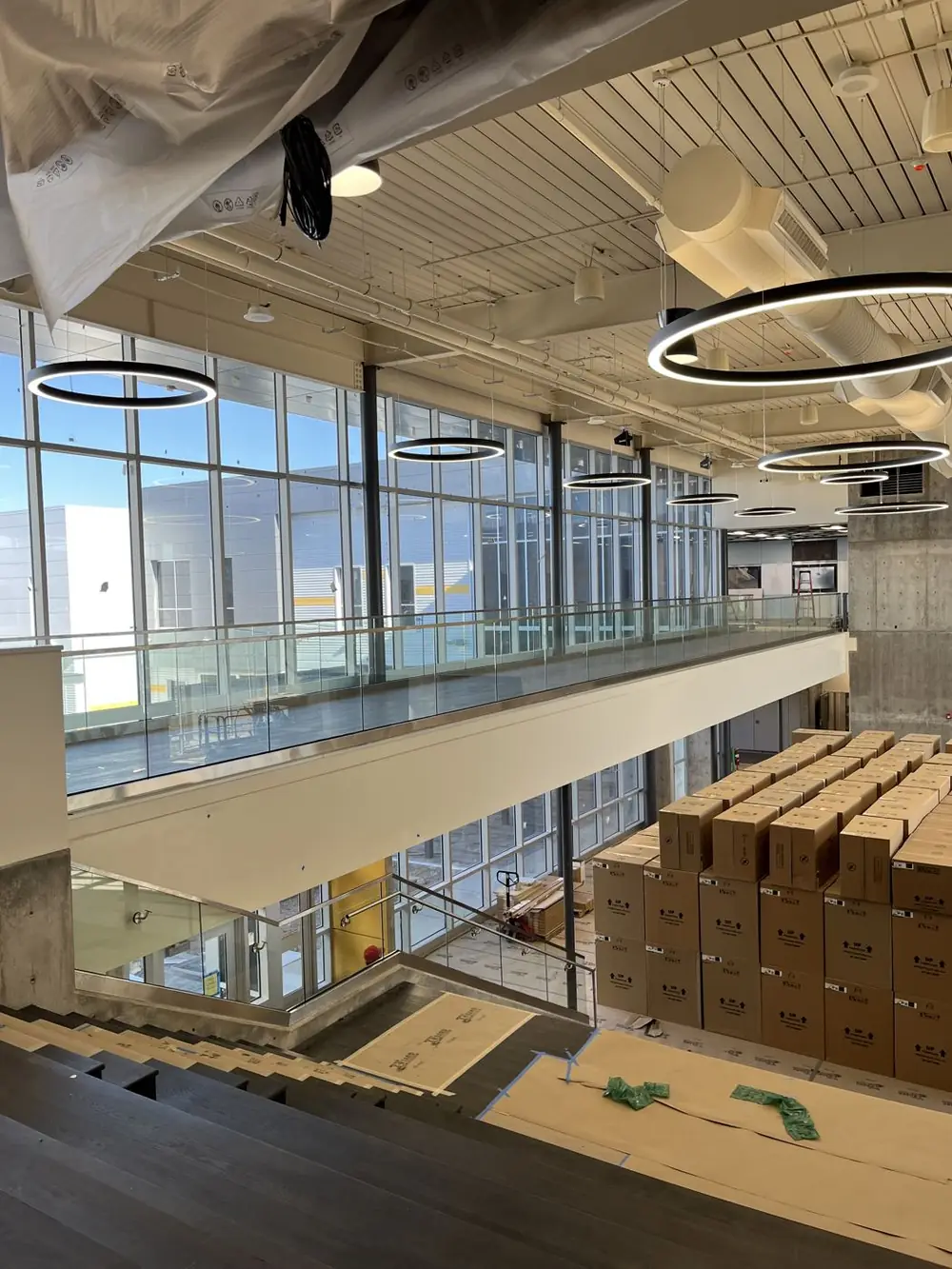

Looking down over the glass guardrail at the mezzanine edge to the commons floor below
Upper level glass, looking down into the commons.
Glass guardrail wrapping the mezzanine edge past a board-formed concrete wall
Mezzanine edge, corridor side

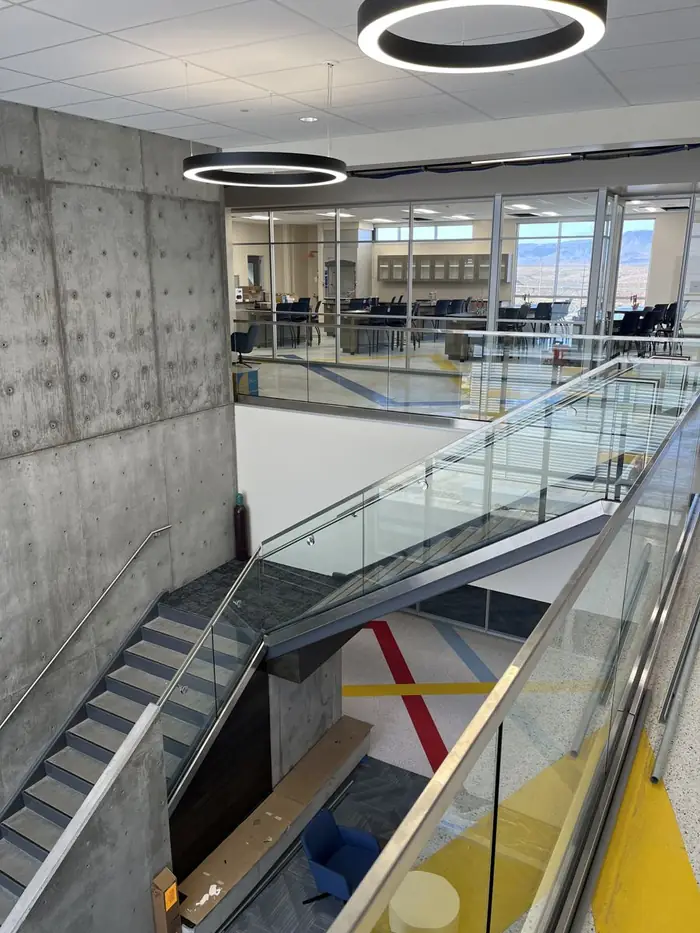

Glass guardrail along the upper edge above the main stair and commons
Above the main stair

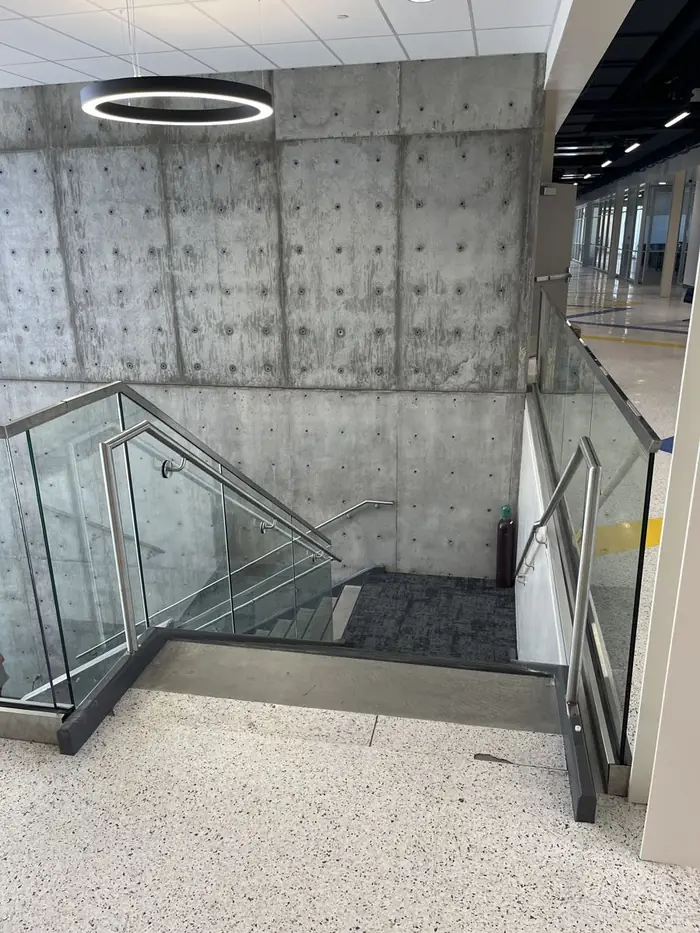

Glass guardrail turning the corner down a stair run with stainless handrail
Stair run and landing turn
~450 LF
Glass guardrail
304 SS
Cap and handrail
5 hr
Each way, shop to site
1 yr
Contract to occupancy

Glass guardrail on a date that will not move?

Schools, arenas and public buildings open when they open. If you have a glass package on the critical path to occupancy, send us the drawings and a bid date.
